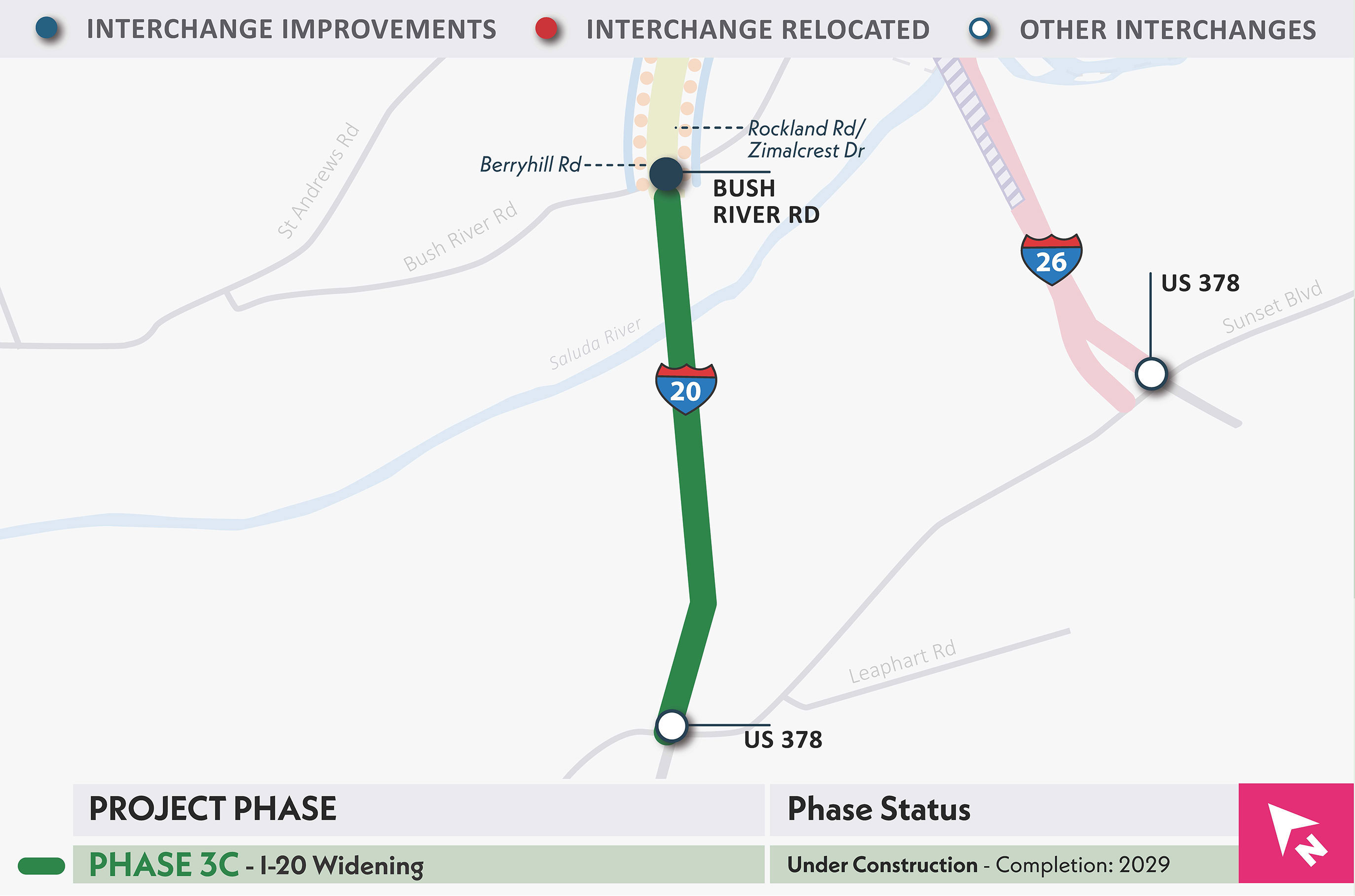

Phase Overview
- Replacement of I-20 bridges over Saluda River and CSX railroad
- Widening I-20 to accommodate future lane additions in later phases. Future lanes will open in coordination with Phase 3E.
- Phase 3E will also include a new interchange at Bush River Road and a ramp improvement from I-20 WB onto US 378.
Stages of Construction

Stage 1: In this stage, all existing lanes will remain open, but slightly narrowed, to create space for shoulder work. Crews will begin constructing the new bridges beside the existing ones, adding new outside pavement, and installing the eastbound noise wall. A temporary eastbound exit ramp to Bush River Road (Exit 63) will keep traffic moving while the permanent ramp is rebuilt, and work will begin on the westbound entrance ramp.

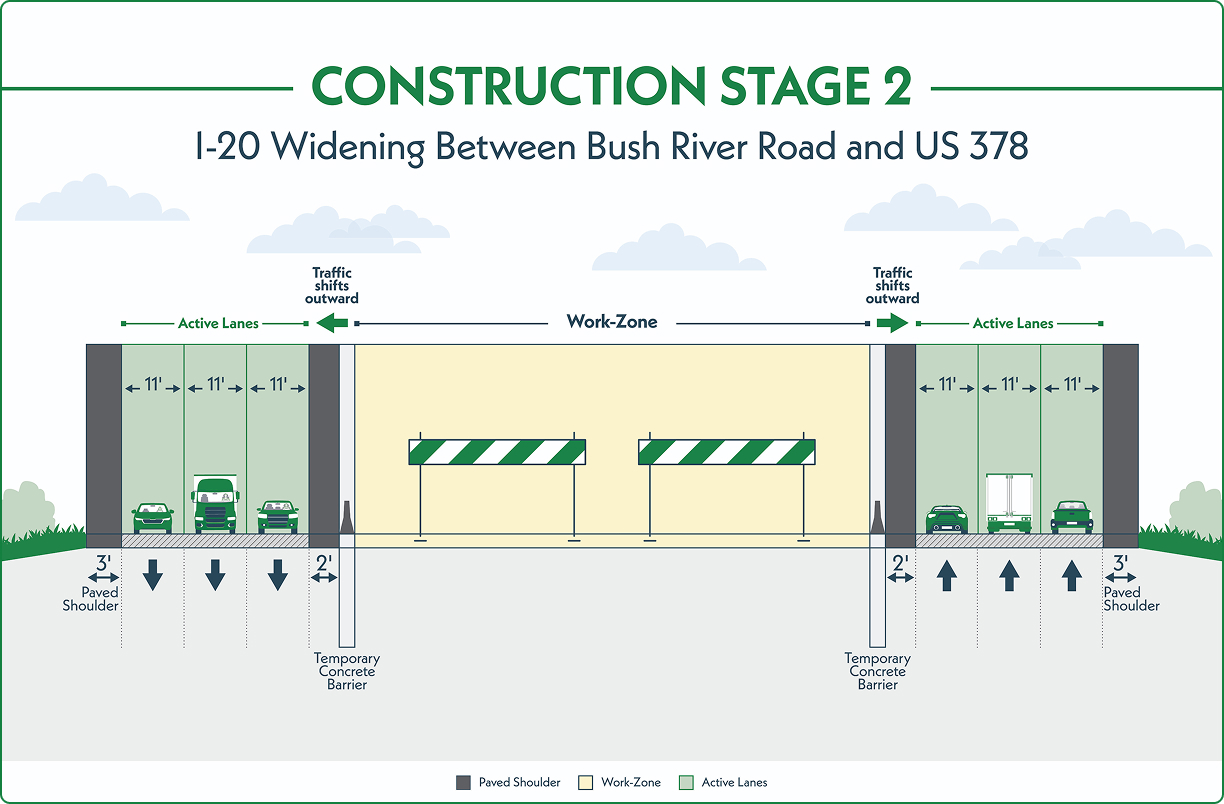

Stage 2: In this stage, traffic will move to the new widened outside lanes, opening the median for construction. Crews will replace the median barrier, install drainage, and build the center sections of the new bridges. When work is complete, traffic will shift into the new alignment, with new pavement markings and signs.

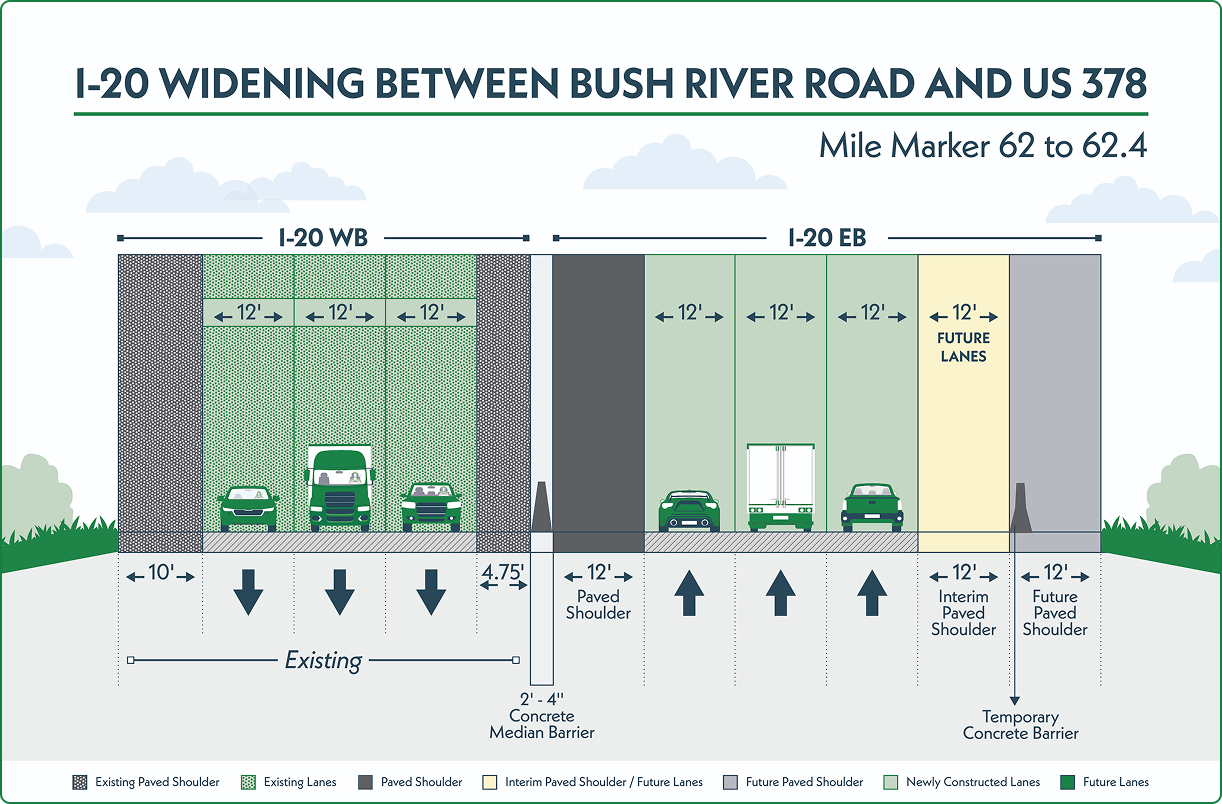

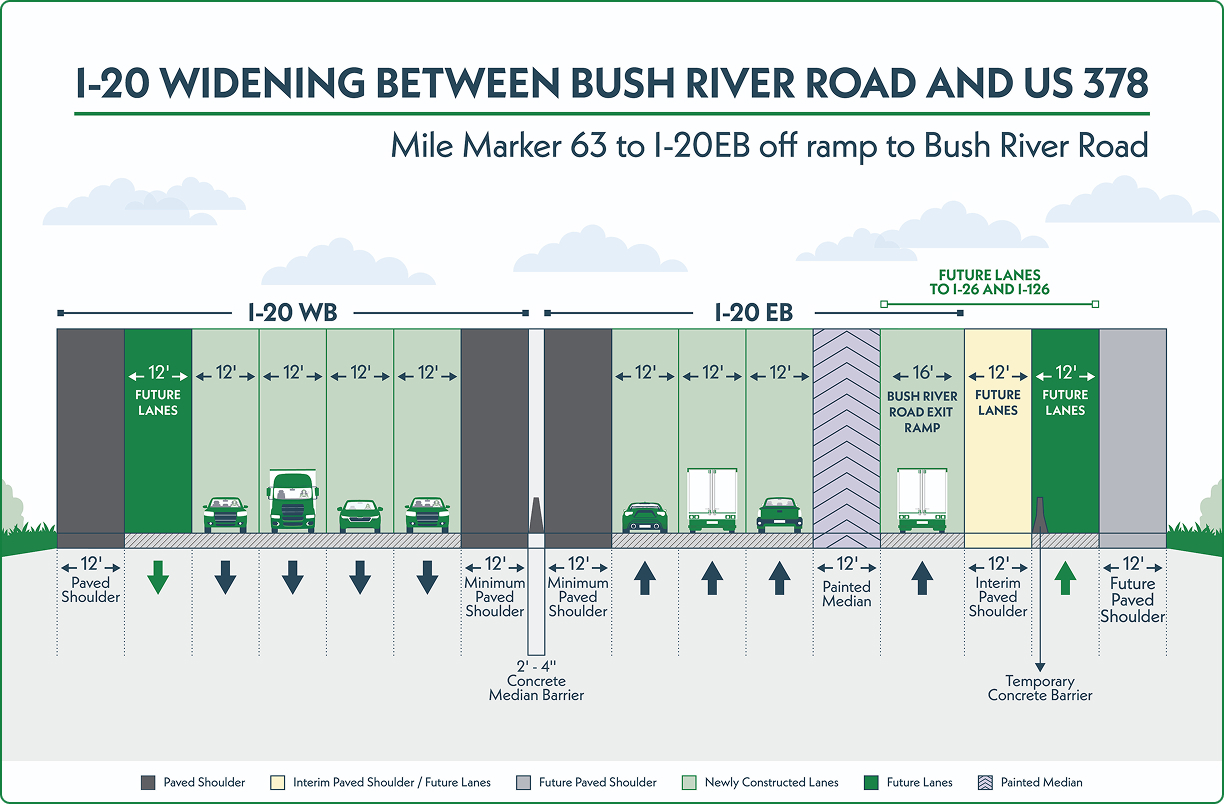

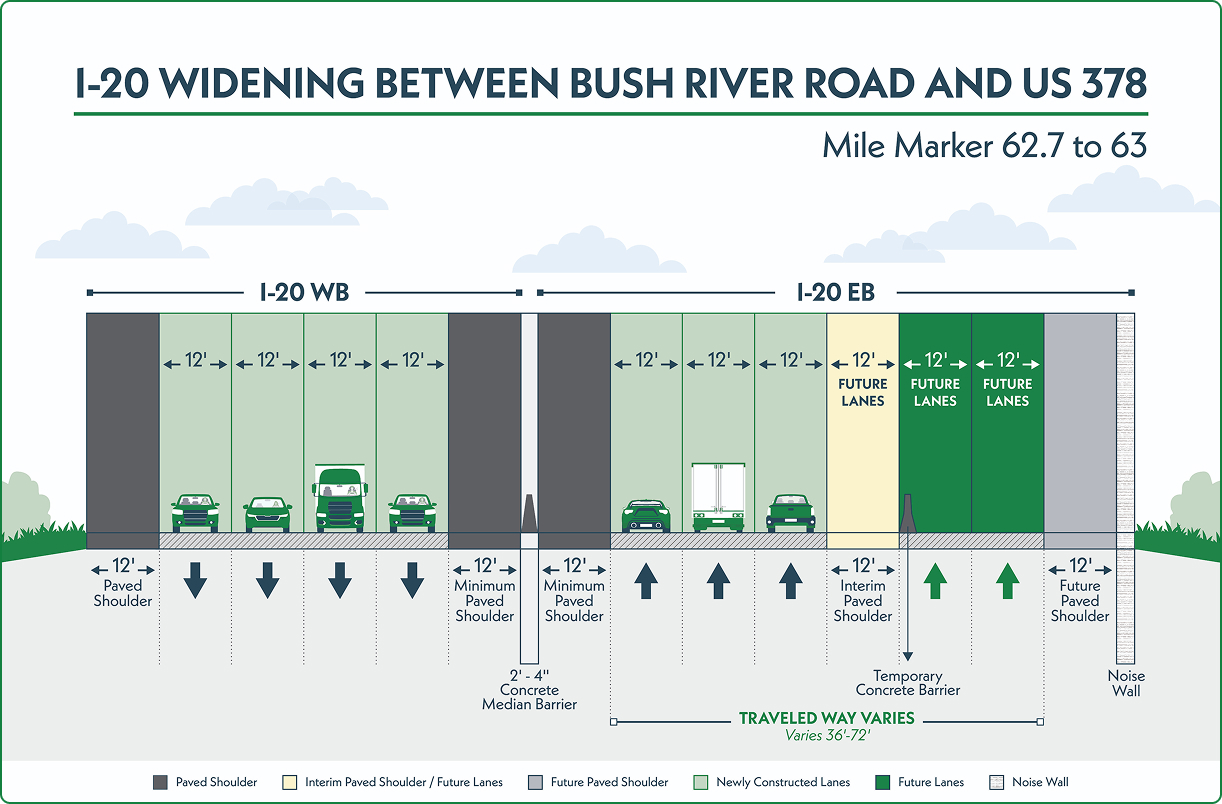

Final Configuration

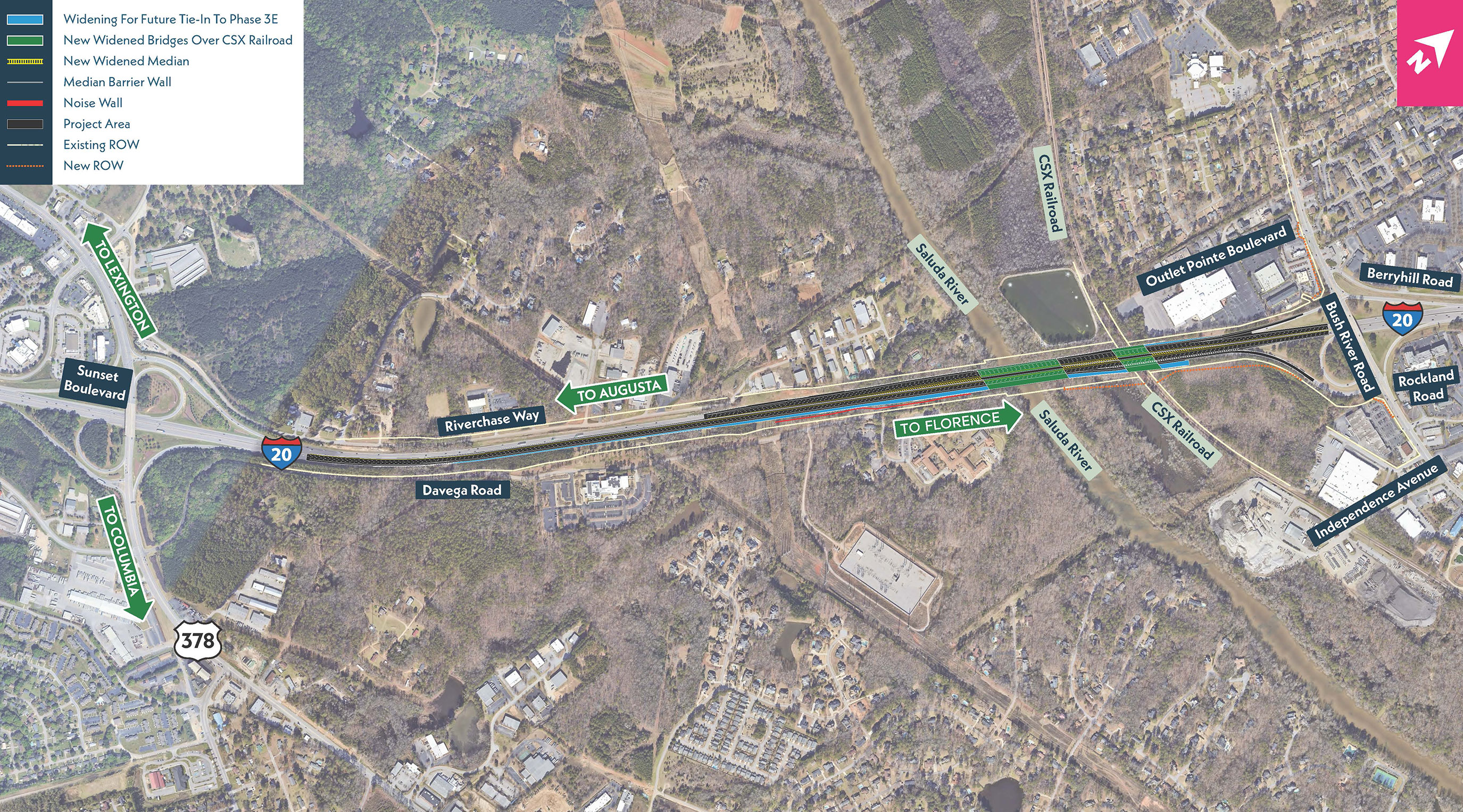

Aerial Map
